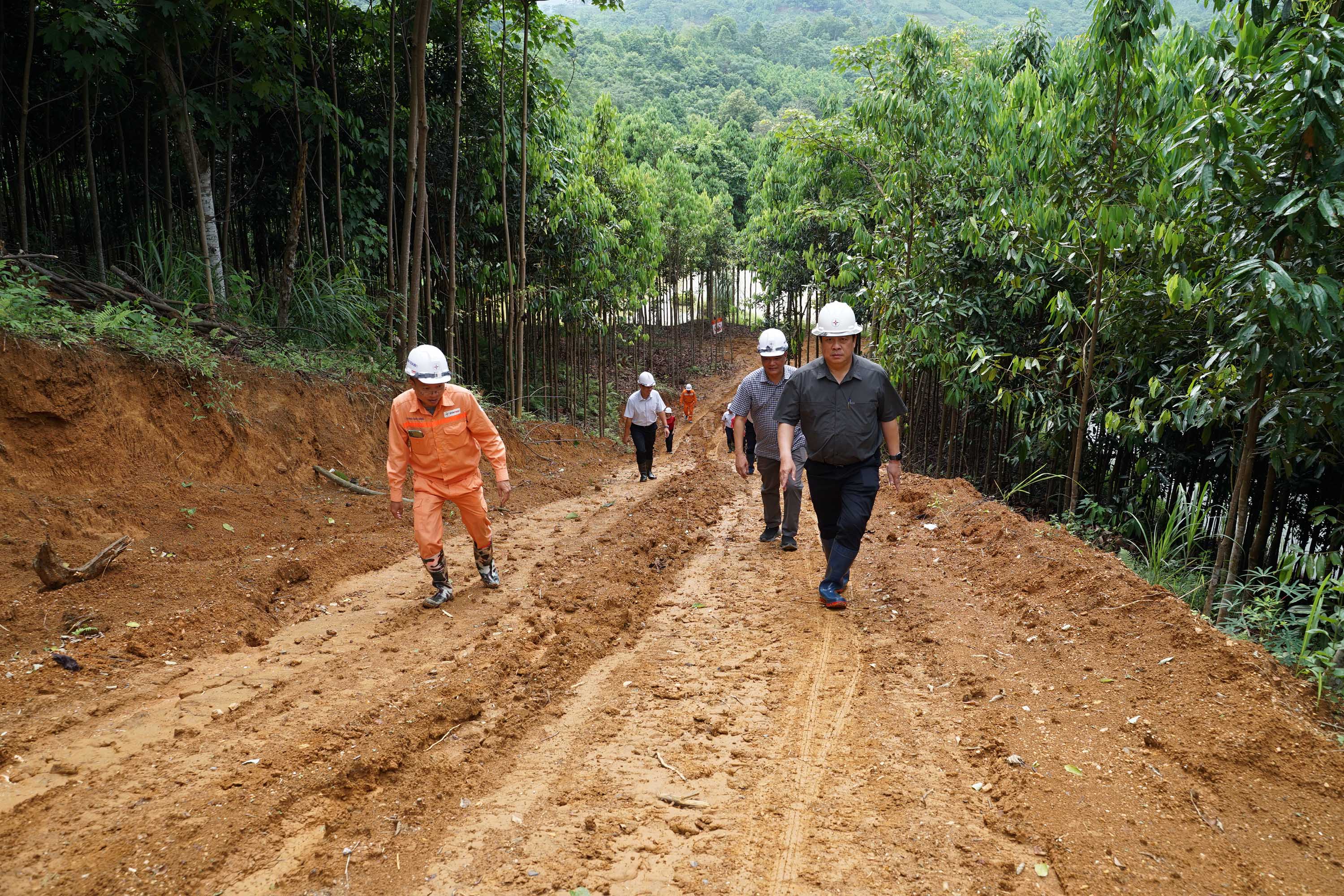

EVN’s President and CEO Nguyen Anh Tuan (leading, right) on his way to inspect location of VT1 pole (Bao Thang district, Lao Cai province) under package 1, undertaken by Joint venture of Song Da Construction and Services Joint Stock Company, PC1 Group Joint Stock Company, and Dong Anh Steel Tower Company Limited

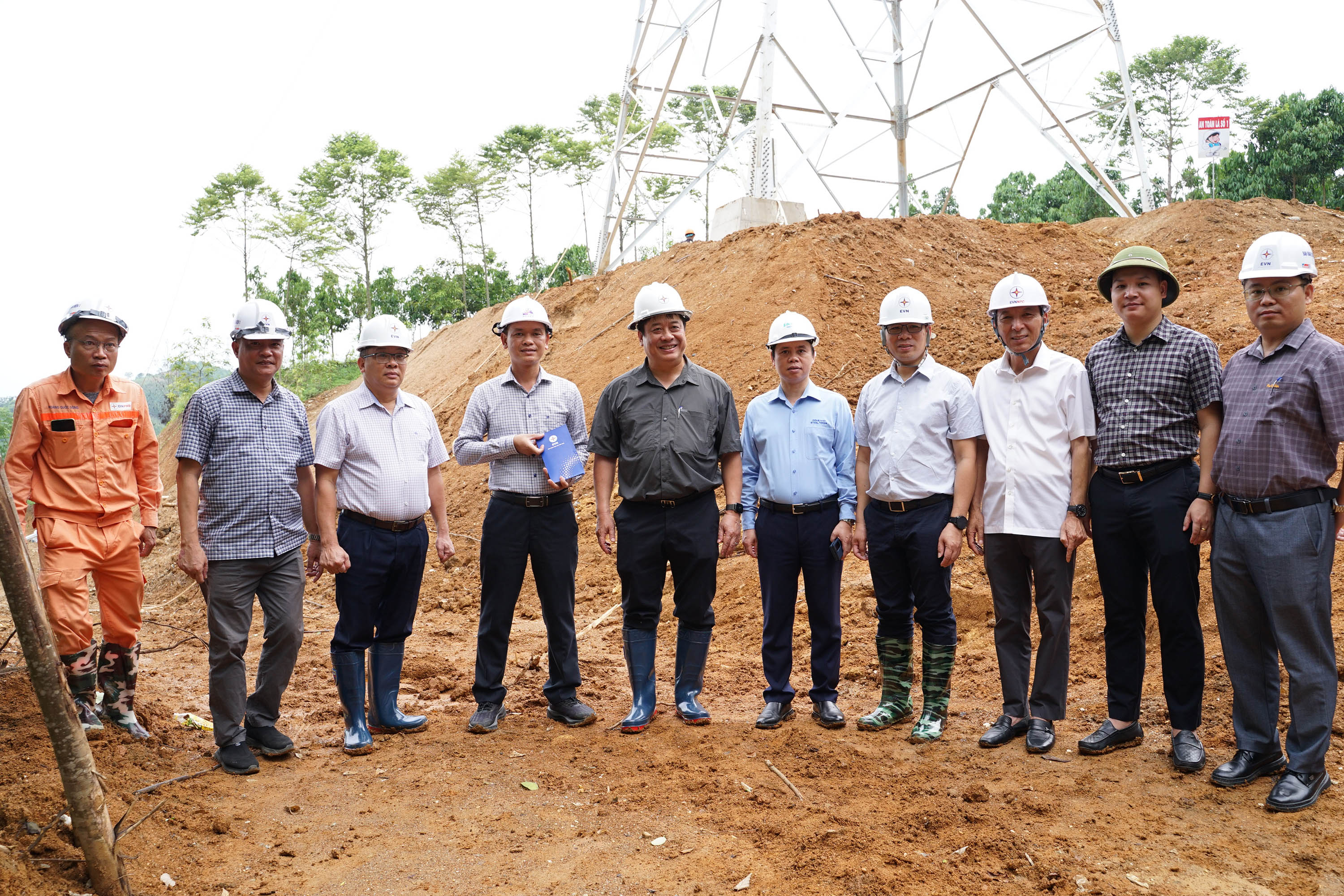

Package 1 is the first package to complete all foundation pit work at 51/51 locations. Therefore, President and CEO Nguyen Anh Tuan (5th from left) and Vice President Pham Hong Phuong (3rd from left) awarding the joint venture contractor for its achievements in construction and supply of steel poles right at the location of VT1’s construction site

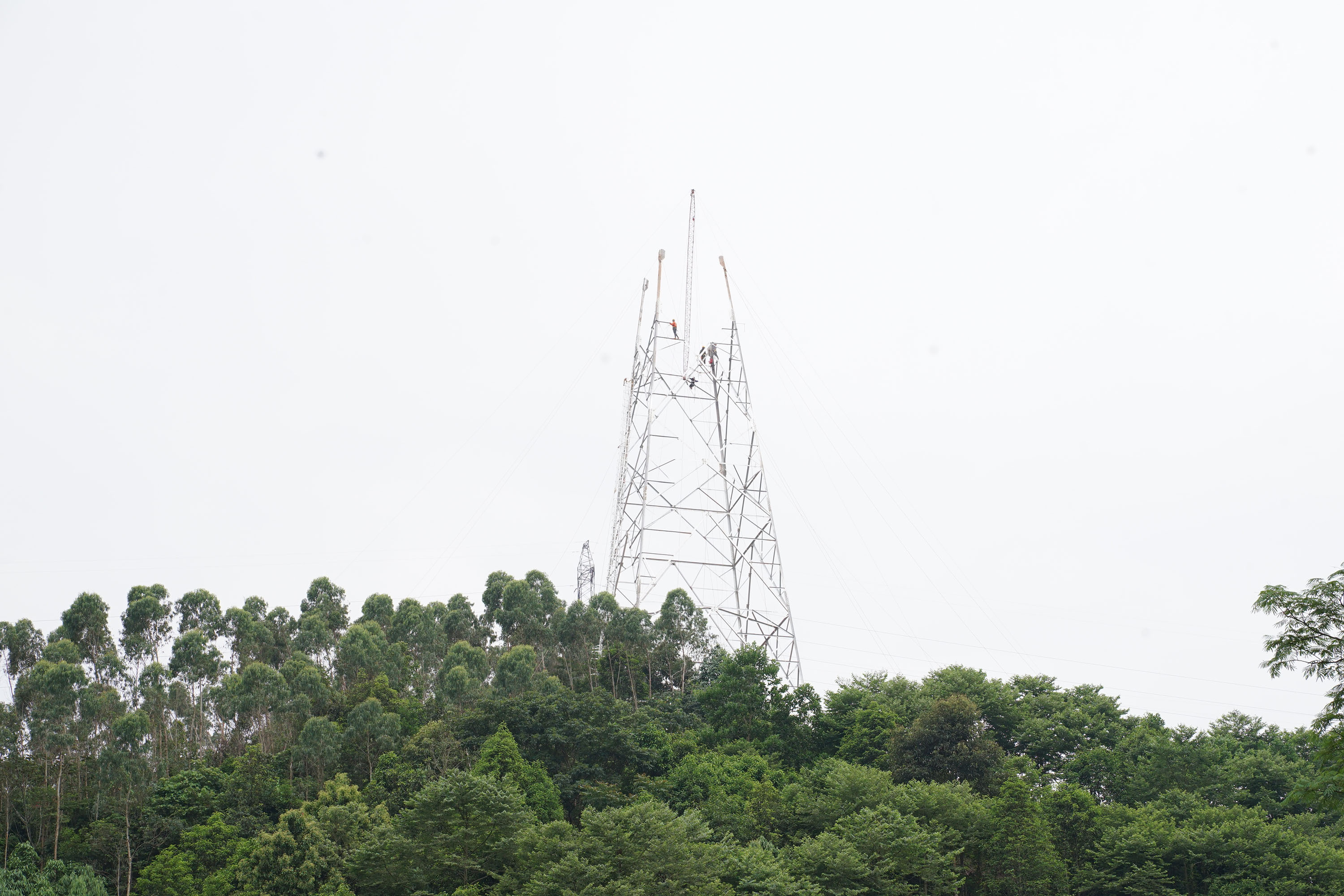

VT61 under Package No. 2 (Bao Yen District, Lao Cai Province), constructed by Power Construction Company No. 4, has also completed foundation pit work and moved on to pole erection, expected to be completed in the next 3 days. This is a great effort made by Power Project Management Board No. 1 and the contractor in the difficult weather and heavy rain context

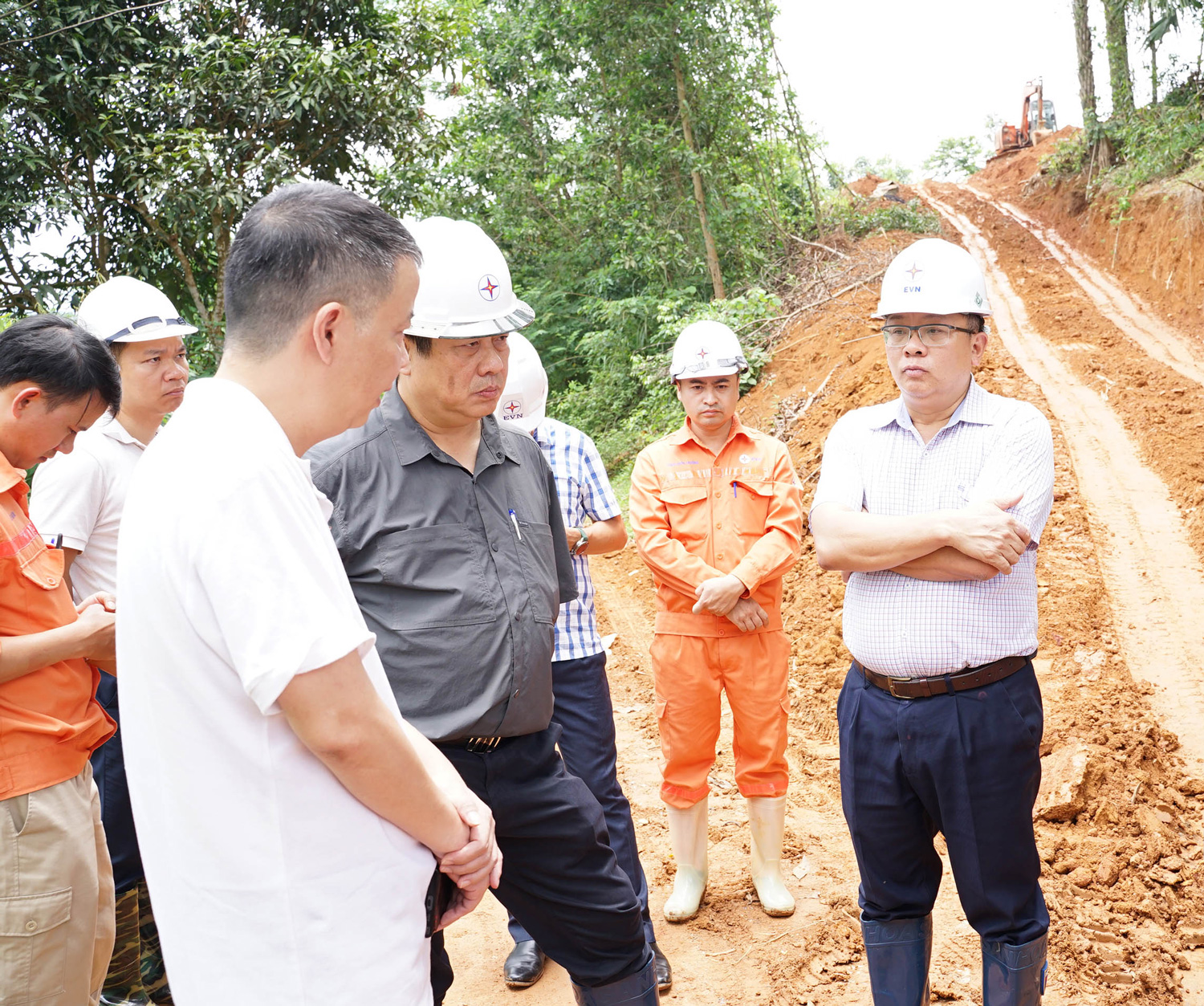

Package 3 is constructed by Hung An Construction Joint Stock Company and Viet Vuong Joint Stock Company, the section through Yen Bai province has 8 locations on the "critical path" (including VT108, VT112, VT117, VT122, VT129, VT135, VT136, and VT140). Some of the construction foundations encounter hard rocks, or the foundations are in the fields, near streams, where water seeps into the foundation pits very strongly with mud. EVN’s President and CEO Nguyen Anh Tuan directed the contractors to have new design solutions, in addition, the contractors must increase human resources, arrange construction reasonably, and take advantage of the dry weather to urgently carry out the work. In the photo: The President and CEO listens to the report on the implementation of package 3 at VT100 (Bao Yen district, Lao Cai province)
