Quang Trach I Thermal Power Project: Striving to fire oil for unit 1 on August 19, 2025

16:36, 13/07/2025

The Quang Trach I Thermal Power Plant Project (Phu Trach Commune, Quang Tri Province) is approaching the milestone of first oil fire of Unit 1. Below are photos taken on July 11-12, 2025.

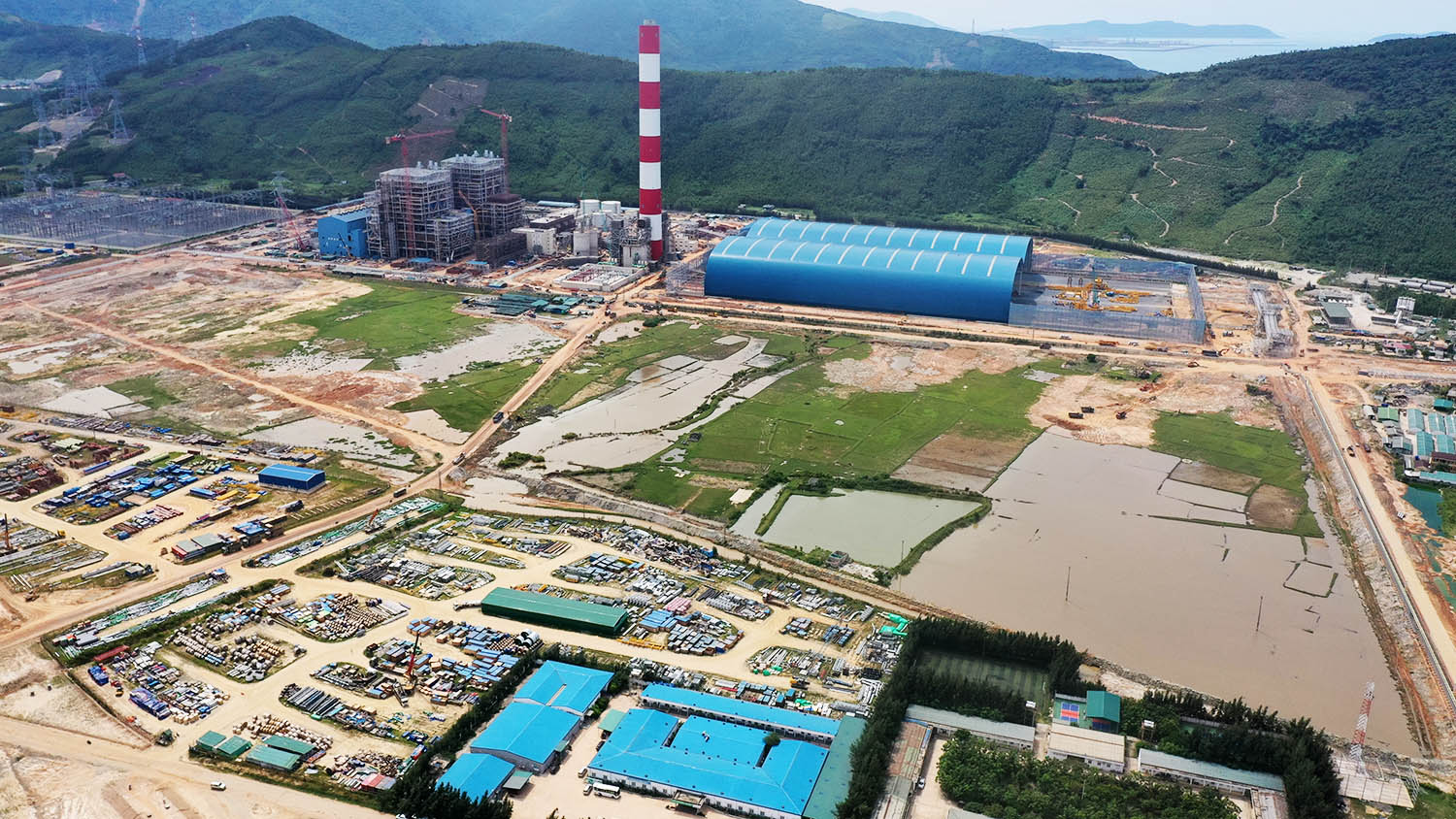

According to information from Power Project Management Board No. 2, as of July 11, 2025, the overall progress of the Quang Trach I Thermal Power Plant project reaches about 94%. In the photo: Panorama of the Quang Trach I Thermal Power Plant construction site.

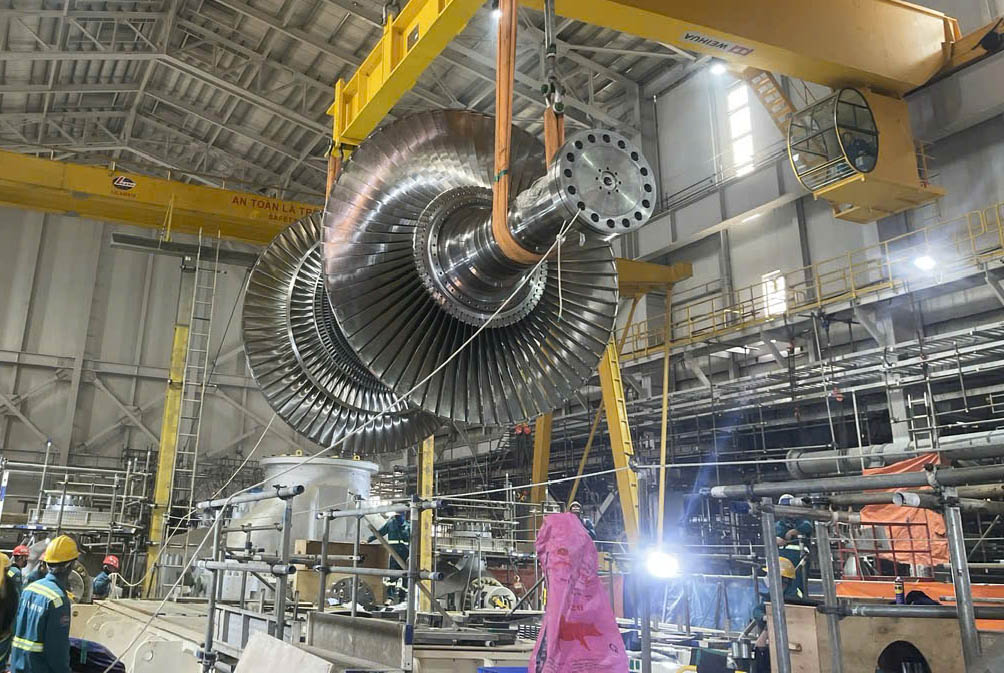

For Unit 1, the turbine and auxiliary equipment have reached 95% of the equipment volume in position, and the first step of the high-pressure turbine has reached 87%. In the photo: Installation of the turbine of Unit 1 on the morning of July 12, 2025.

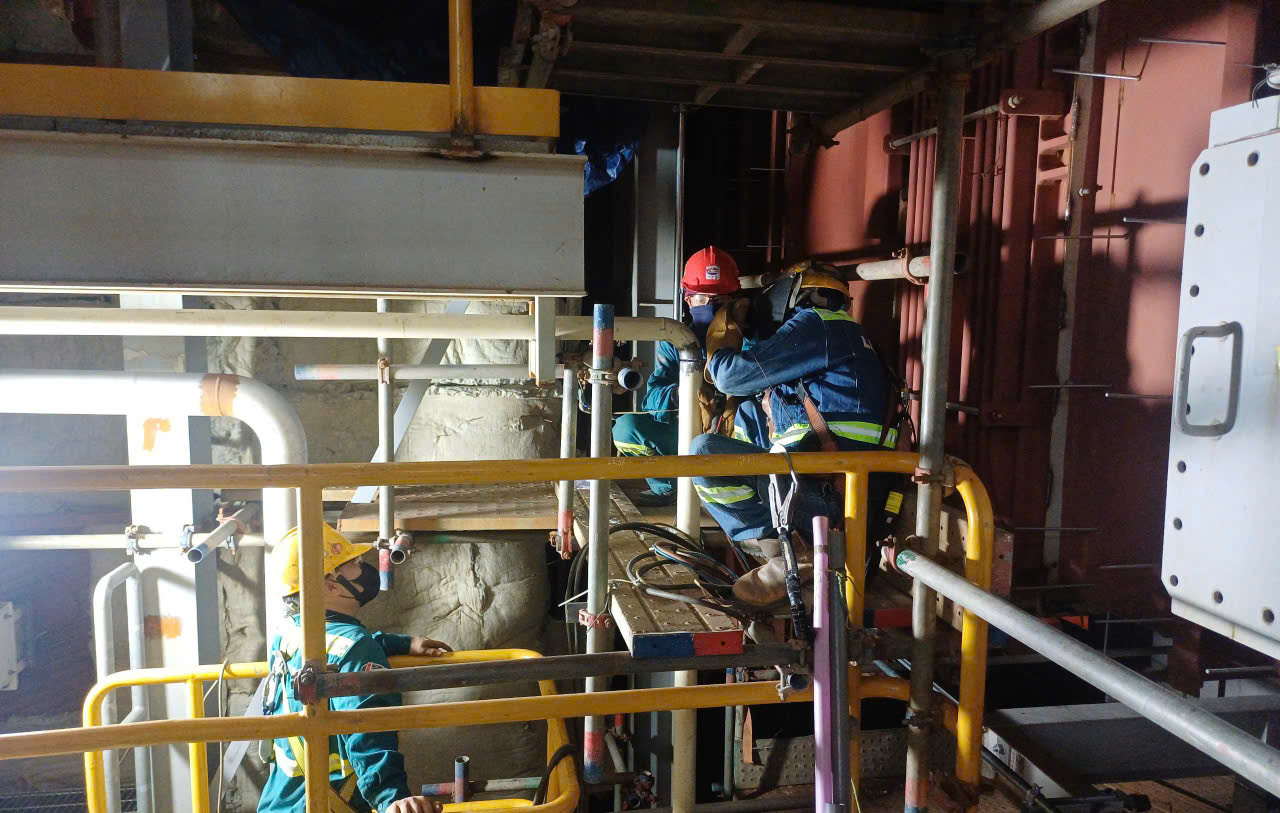

Regarding the installation of boiler No. 1, the main steel structure is 96% complete, the boiler body has reached 100% of the installed volume, and the crusher is 100% completed. In the photo: Workers are installing insulation panels at boiler No. 1 on July 11, 2025.

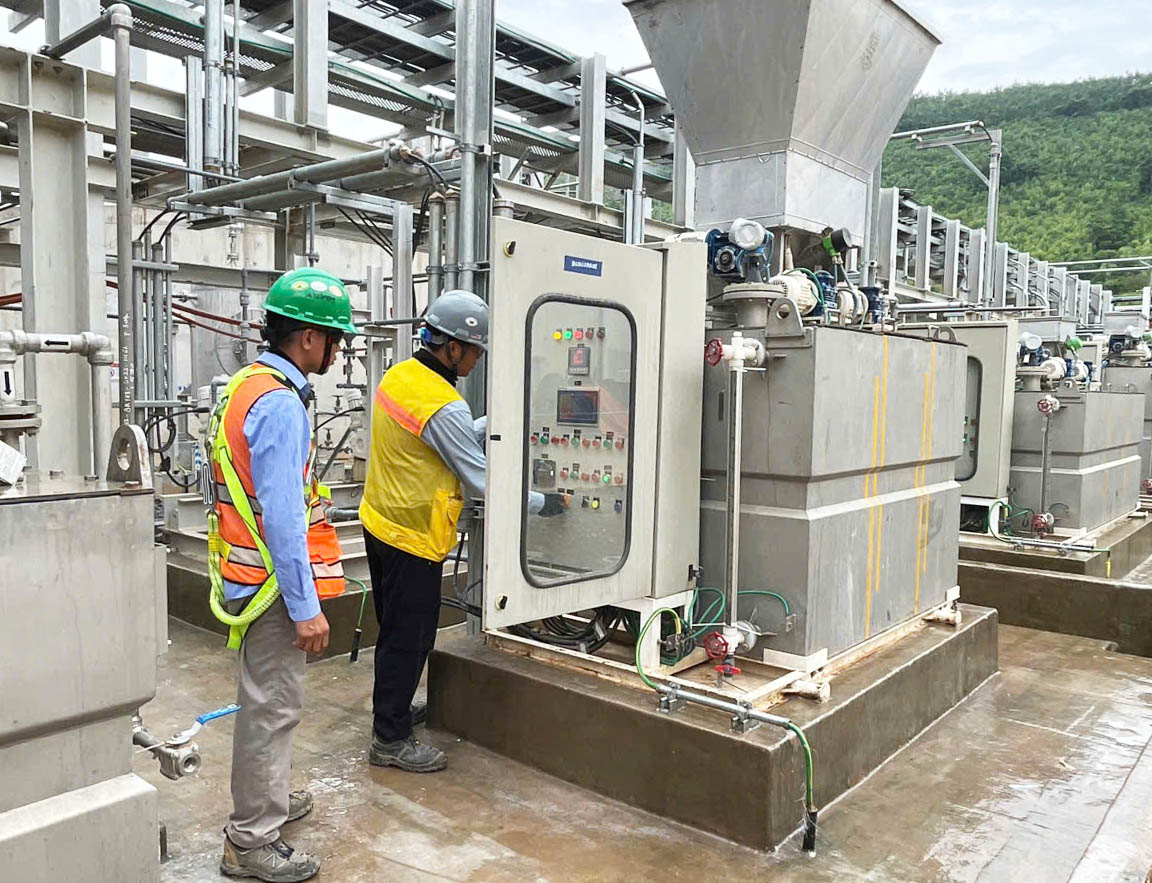

Workers are testing the factory's wastewater treatment system. When the furnace is fired for the first time, the wastewater will be treated according to the correct process to ensure environmental hygiene.

The DO oil tank was completed and put into operation to receive oil.

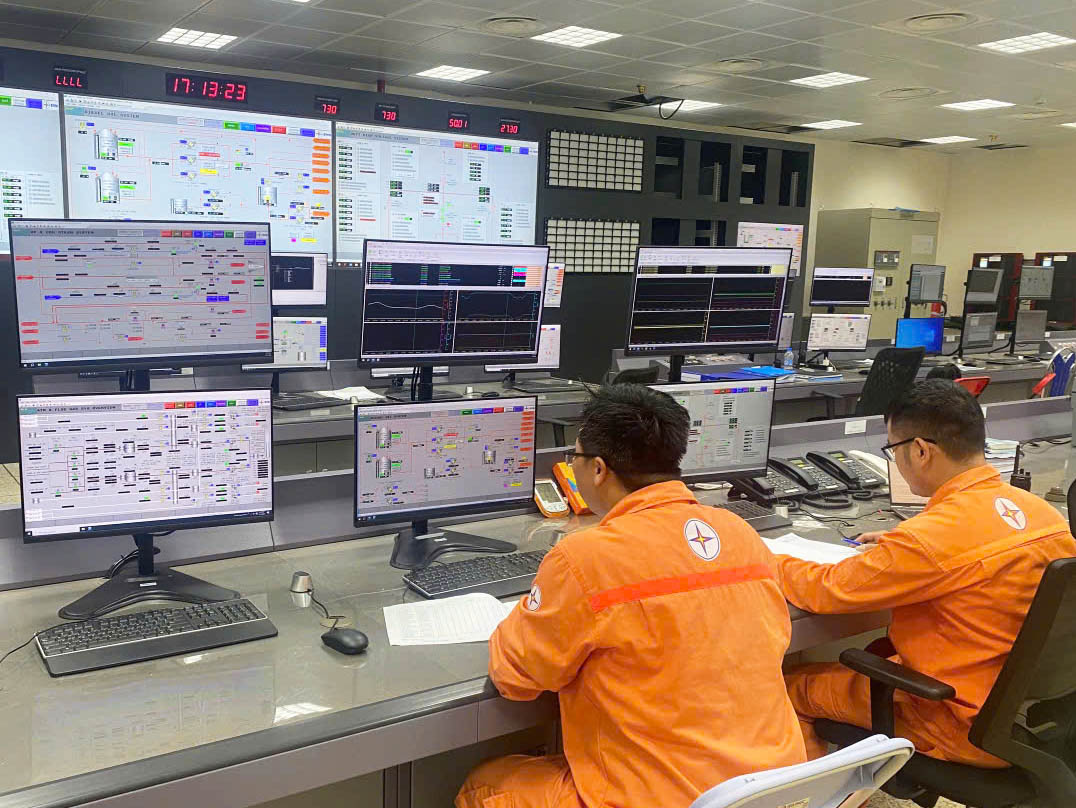

Production staff conduct testing in the central control room.

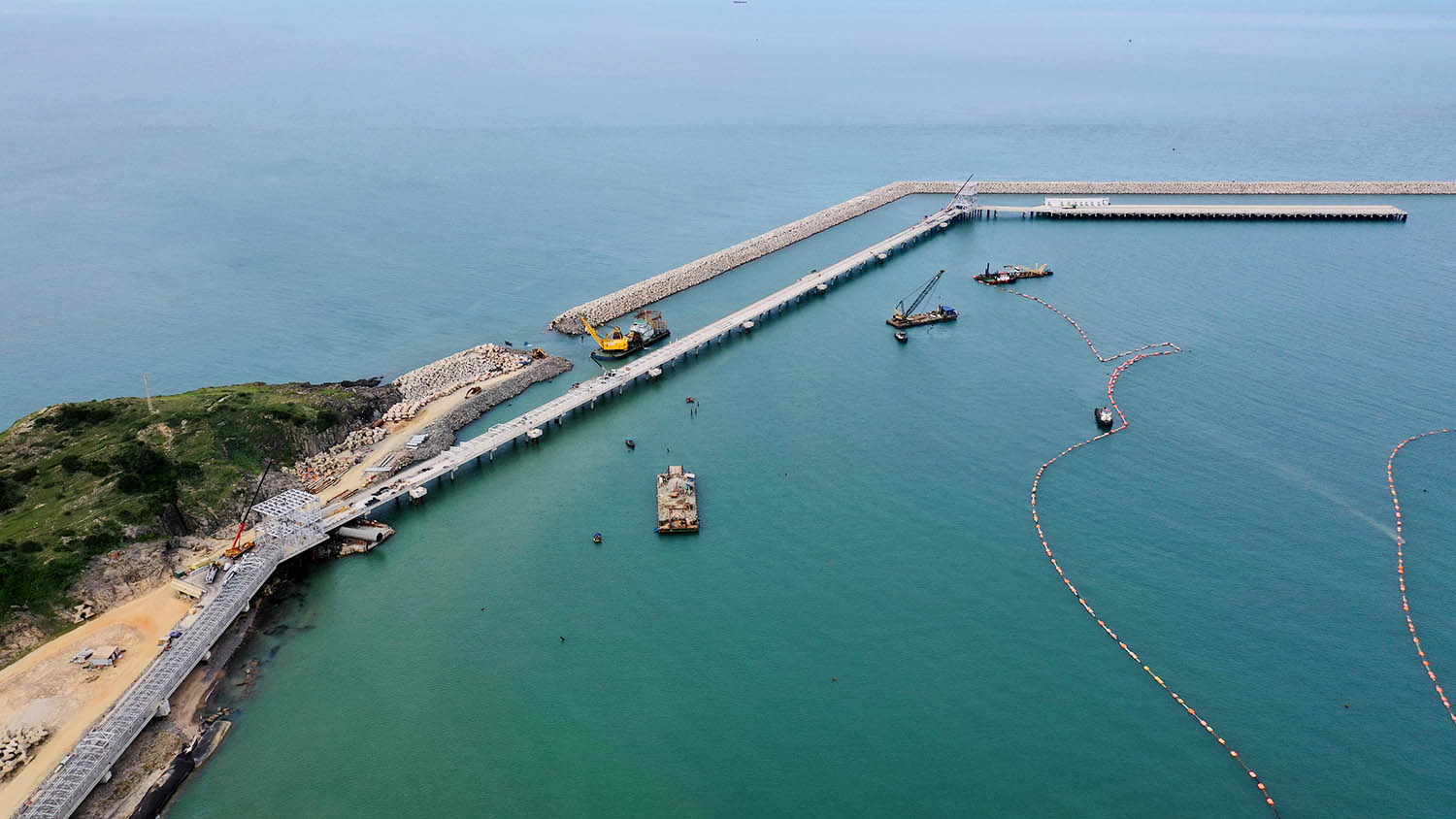

The coal import port approach bridge and breakwater have been completed construction and coal receiving equipment is being installed.

Quang Trach I Thermal Power Plant Project:

- Investor: EVN

- Project management representative: Power Project Management Board No. 2

- Construction site: Phu Trach Commune, Quang Tri Province (formerly Quang Trach District, Quang Binh Province)

- Total area: Over 48.6 hectares

- Scale: 2 units, total capacity of 1,403MW

- Average annual electricity output: About 9.1 billion kWh
