EVN Vice President Pham Hong Phuong Inspects construction site of Bac Ai Pumped Storage Hydropower Plant – Khanh Hoa Province
17:14, 26/01/2026
On the morning of January 25, EVN Vice President Pham Hong Phuong and a working delegation of Vietnam Electricity (EVN) visited and inspected the construction progress of the Bac Ai Pumped Storage Hydropower Project (Bac Ai Tay Commune, Khanh Hoa Province).

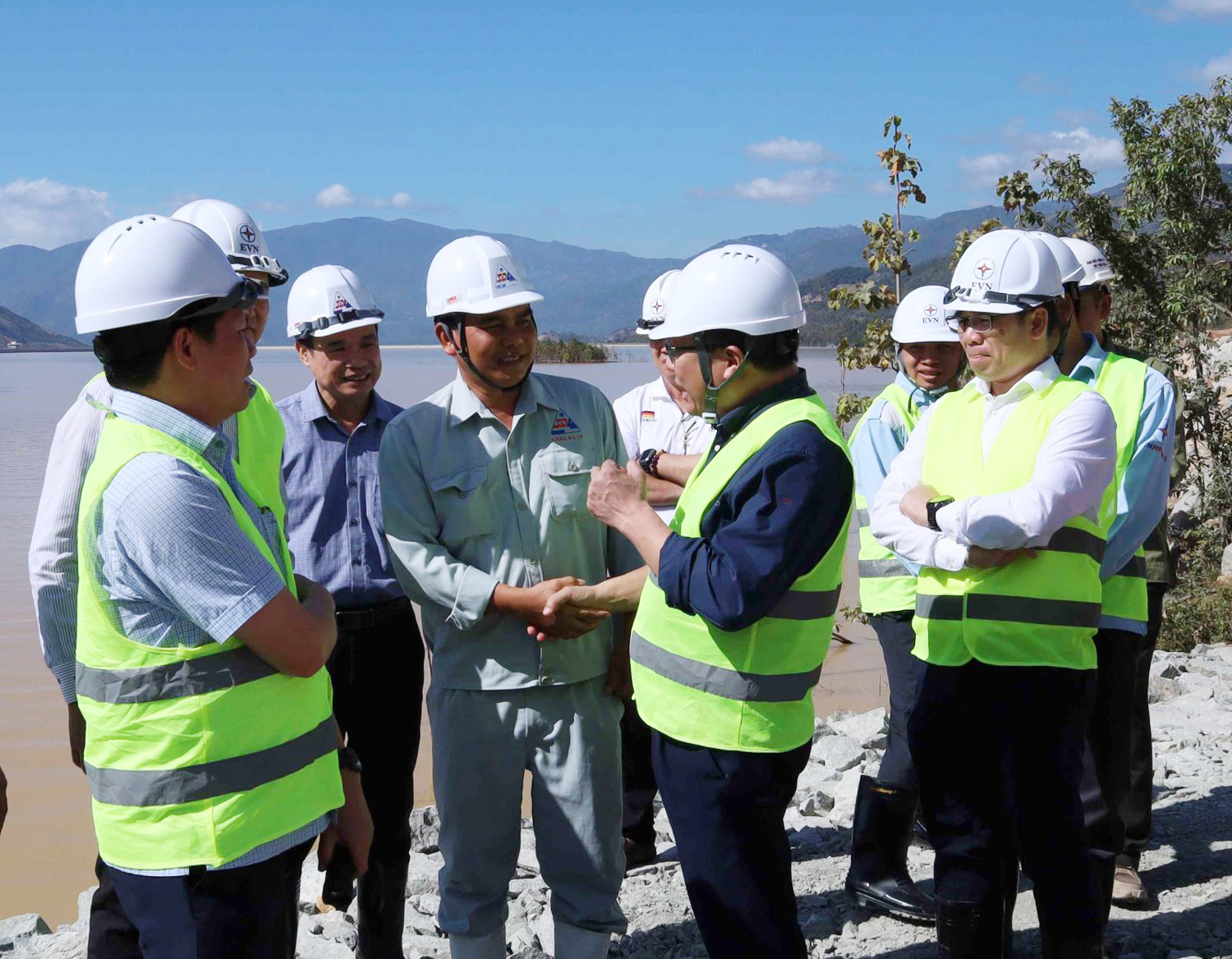

The Bac Ai Pumped Storage Hydropower Project (4 units, total capacity of 1,200MW) plays a critically important role in “peak shaving and baseload filling” of the load curve. When completed (expected in 2030), Vietnam’s first pumped storage hydropower plant will also be the largest and most modern in Southeast Asia. In the photo: EVN Vice President Pham Hong Phuong (dark purple shirt) listens to progress reports from construction contractors.

To date, the internal access road system (VH1, VH2, VH3A) serving construction and operation, with a total length of several tens of kilometers, has basically been completed, ensuring smooth access for heavy vehicles and contributing to accelerated construction progress. In the photo: VH1 access road has been completed 100%.
The construction package for underground works is one of the most challenging components of the project. Contractors have introduced many technical innovations, optimizing blasting and earth–rock transportation processes to speed up progress. In the photo: Outside portal of VH3A tunnel (left); power cable - ventilation tunnel, and construction tunnel (right).

In 2025, the site completed the connection of construction and operation access roads; finished excavation of open foundations for major structures; and carried out excavation of power cable tunnels, drainage tunnels, construction tunnels, and ventilation tunnels. In the photo: EVN Vice President Pham Hong Phuong encourages contractors to maintain progress and strive to achieve and surpass key targets for 2026.

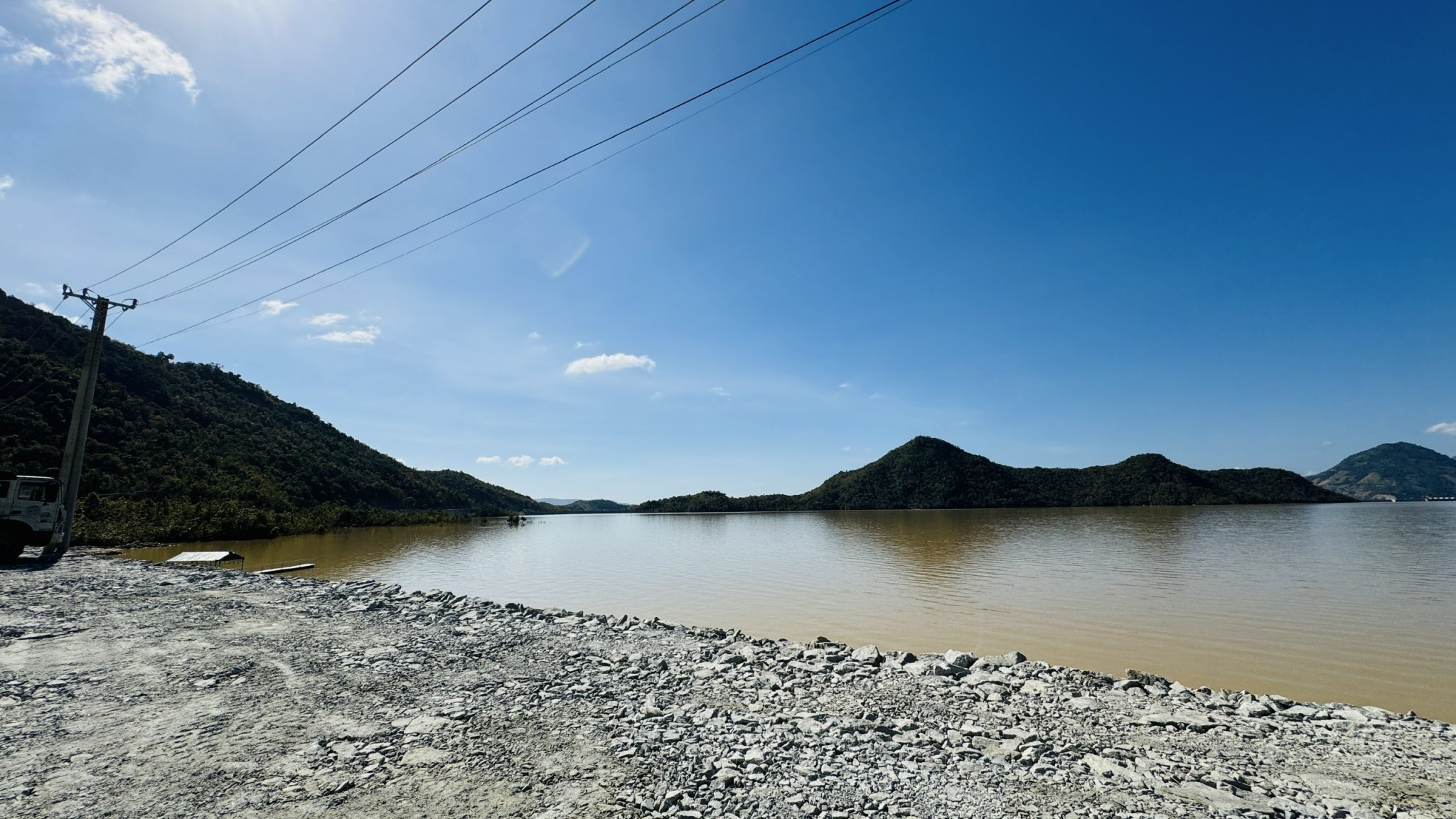

The Song Cai Reservoir, part of the Tan My irrigation system, provides the water source for operating the Bac Ai Pumped Storage Hydropower Plant.
After the site inspection, EVN Vice President Pham Hong Phuong will hold a site coordination meeting with EVNPMB3 and the contractors.
